Group Captive & Open Access
An SPV you part-own supplies power over the PSPCL network — cross-subsidy surcharge exempt, with tariff visibility for the life of the plant.
How it works →Solar infrastructure built around your business. From rooftop systems to Group Captive and Open Access, we bring development, engineering and long-term operations together.
Statutory thresholds under the Electricity Rules, 2005 and typical Punjab resource figures — the four numbers every industrial solar decision is built on.
An SPV you part-own supplies power over the PSPCL network — cross-subsidy surcharge exempt, with tariff visibility for the life of the plant.
How it works →Shed and factory rooftops converted to generation under net metering, sized to daytime load and structurally verified before a single module lands.
How it works →MW-scale plants on acquired or leased land, engineered around evacuation capacity and HT connectivity from the first site visit.
How it works →We fund, build, own and operate. You sign a long-term PPA and pay only for the units you consume, at a rate below your grid tariff.
How it works →Review the proposed system, commercial terms and financial assumptions together. Our proposal brings the technical scope, generation estimate and project economics into one clear document.
What separates a project that saves money from one that stalls is everything between your meter and the substation — and knowing, before you commit, which of it will actually clear.
PSPCL, PSERC and SLDC processes, current open access charges, banking rules and the exemptions that apply to your category.
Generation, degradation and CUF assumptions written down so a lender or your finance team can audit the number, not just receive it.
If the numbers do not work at your site, you hear it at stage one — not after you have paid for a detailed project report.
Captive status must survive at 26% equity and 51% consumption year after year — we structure and document it to be defensible.
Forging, textiles, hosiery, auto components, foundries and food processing — plants with real daytime load and real HT connections.
Structural verification, shadow analysis, evacuation study and wind-load rated structures before procurement is released.
Monthly settlement against consumption, banking reconciliation and performance reporting for the life of the plant.
Feasibility, structuring, approvals, EPC and O&M under a single contract — no gaps between vendors for a problem to hide in.
Six stages, in this order. Nothing after stage two can be fixed by better engineering, which is why we spend real time at the front.
Twelve months of PSPCL bills, load pattern and tariff category analysed to size the plant against actual daytime consumption.
Land, irradiance, soil, and — decisively — evacuation headroom at the nearest substation and the wheeling route to your plant.
Special purpose vehicle incorporated, your 26% equity and 51% consumption commitment documented to survive an audit of captive status.
Open access application, connectivity, PSERC-notified charges, SLDC scheduling and metering registration handled end to end.

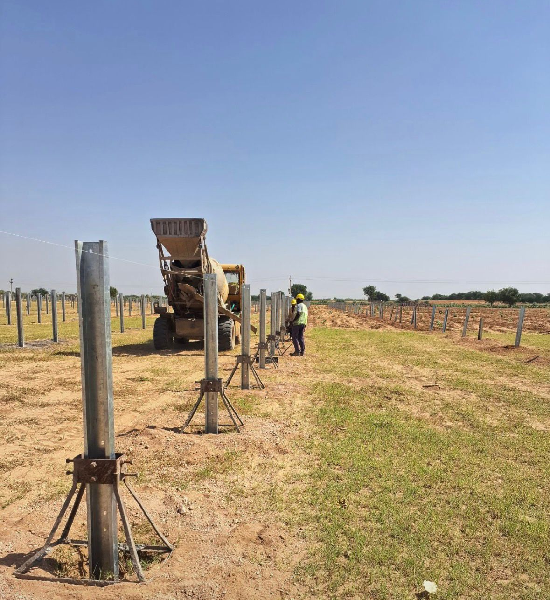

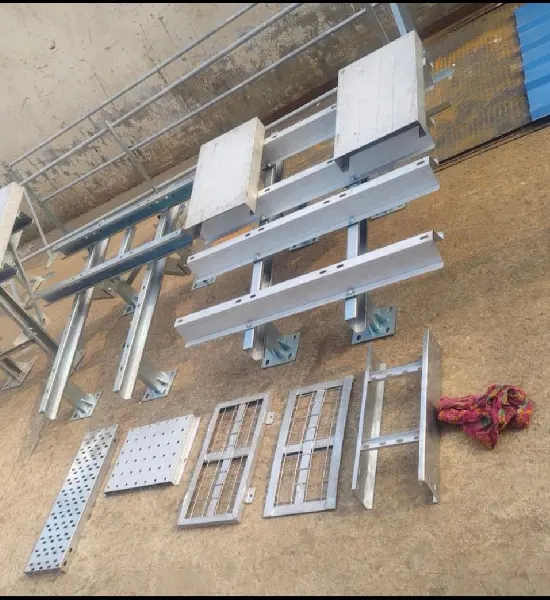

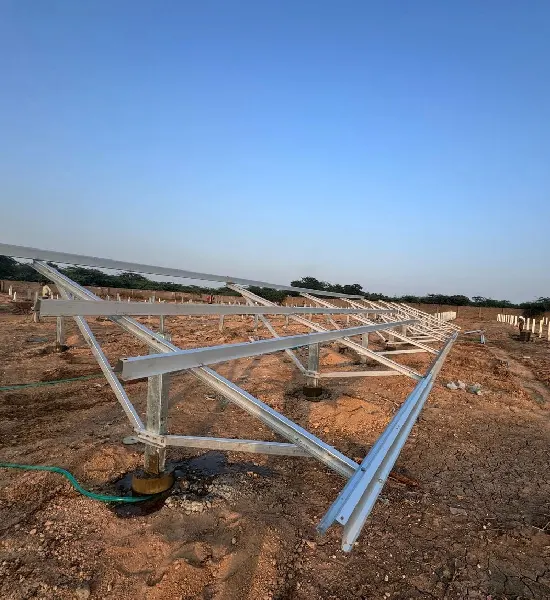

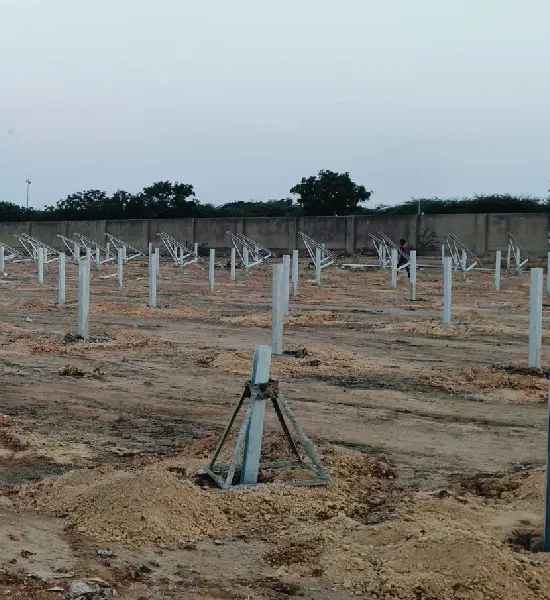

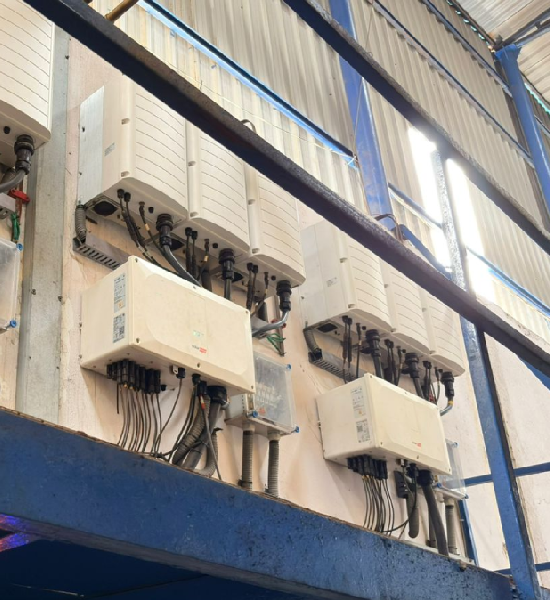

Procurement, civil, structures, DC and HT works, testing and charging — delivered to a schedule you can build a budget on.
Monthly settlement against your consumption, banking reconciliation, cleaning and preventive maintenance for the plant's life.
Three phases, each with its own risks. We carry all three so nothing falls between contractors.
Everything that decides whether the project is worth doing. Consumption analysis, site and land feasibility, evacuation headroom, SPV structuring and every approval that has to clear before a rupee is committed to hardware.
With approvals in hand, execution moves to a schedule you can budget against — detailed engineering, procurement of specified equipment, civil and structural works, DC and HT systems, testing and grid charging.

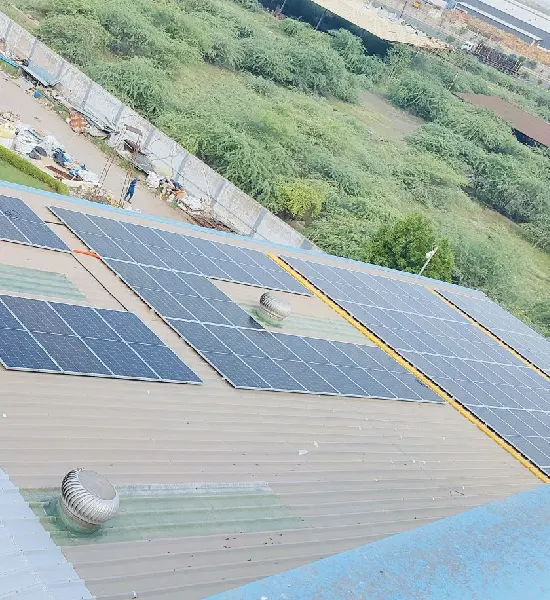

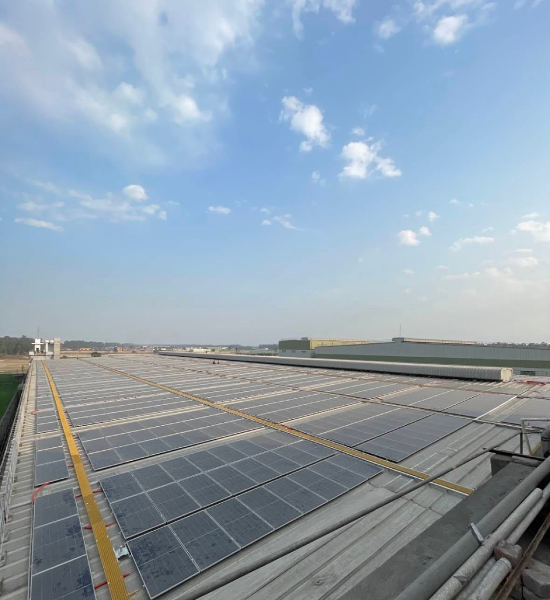

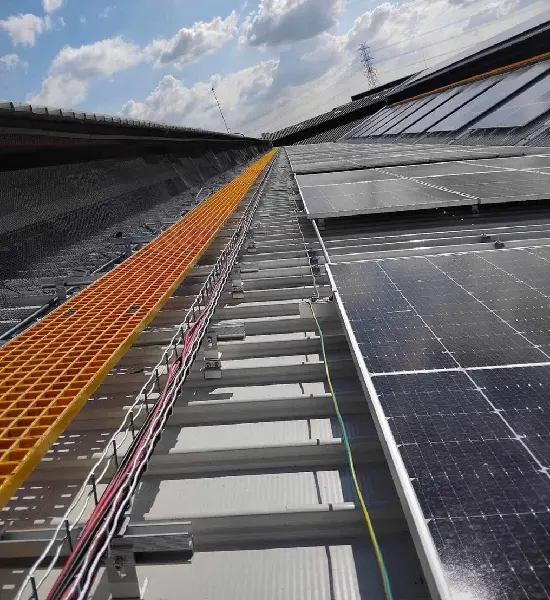

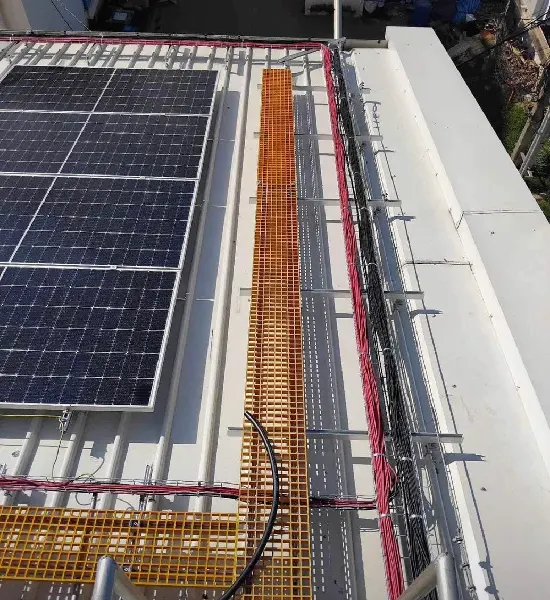

Generation only becomes savings if it is measured, settled and maintained. We stay on the asset — monitoring output against the model, reconciling banked units and keeping performance where the proposal said it would be.
Representative project profiles. Capacities are indicative of the segment, not a claim about a specific commissioned plant.
B.Tech (LLR College, Moga, 2018). Before founding BPD, built a 200+ MW track record across O2 Power, Juniper Green Energy and Aditya Birla — Group Captive, open access and utility-scale rooftop.
"Most industrial consumers are not short of solar offers. They are short of a straight answer on whether the project clears at their substation, and what it is actually worth per year. That answer is what we sell."
We started BPD Developers to work the part of this business most vendors skip — the regulatory and engineering diligence that decides whether an industrial solar project delivers the savings it promised, in year one and in year twenty.
About the companyIf your question is not here, send it directly — we answer with numbers, not brochures.
Ask us somethingThat is all we need to tell you what solar is worth to your plant — capacity, model, indicative tariff and payback, with the assumptions written down.
BPD Developers Pvt. Ltd. develops, builds and operates solar generation for industrial and commercial consumers in Punjab. We work at the point where energy regulation, engineering and plant economics meet — because that is where industrial solar projects are actually won or lost.
We take an industrial consumer from a stack of electricity bills to a commissioned, correctly registered solar plant — and then keep it generating. That covers feasibility and DPRs, financial modelling, SPV and Group Captive structuring, open access and connectivity approvals, EPC delivery, and long-term operations, maintenance and energy accounting.
Our base is Ludhiana, and our work is shaped by the industry around it — forging, textiles, hosiery, auto components, foundries and food processing. Plants with real daytime load, real HT connections, and finance teams who want the assumptions spelled out.
| Entity | BPD Developers Pvt. Ltd. |
|---|---|
| Base | Ludhiana, Punjab |
| Focus | Group Captive, Open Access, C&I rooftop, ground mount |
| Regulators | PSPCL, PSERC, Punjab SLDC |
| Models | CAPEX, RESCO / PPA, Group Captive SPV |
| Scope | Feasibility → approvals → EPC → O&M |
Before founding BPD, Varinder Singh's project development and execution career ran across three developers — the same discipline now runs BPD's own pipeline.
Figures above are the founder's personal project-development track record at prior employers, stated for context on the team's experience — not a claim that BPD Developers Pvt. Ltd. itself built, owns or operates those plants.
B.Tech, LLR College, Moga (2018). Leads project development and the regulatory side of the business — feasibility, Group Captive and open access structuring, generation and financial modelling. Prior track record: O2 Power and Juniper Green Energy, 200+ MW across Rajasthan, Gujarat and Maharashtra.
Every proposal starts with your consumption data and the connectivity position at your nearest substation. If a site does not support the capacity, that is the first thing we tell you.
Irradiance source, CUF, degradation, auxiliary and transmission losses, escalation, applicable charges — written into every model so your finance team can audit the number.
Captive status has to hold at 26% equity and 51% consumption year after year. We structure and document projects to be defensible at every annual verification.
Our involvement does not end at charging the plant. Monthly energy accounting, banking reconciliation and preventive maintenance keep the savings on the books.
Work-at-height protocol, electrical isolation and permit-to-work discipline for every HT activity, with a named safety point of contact on each site.
Material inspection on receipt, torque and continuity checks, string-level testing and thermographic scanning before handover.
As-built drawings, test reports, warranty certificates and O&M manuals handed over as a complete set — not chased for months afterwards.
A short conversation and your last twelve bills are enough for a first, honest answer.
Four delivery models. The right one is decided by sanctioned load and consumption pattern, available roof or land, your PSPCL tariff category, and whether you want to own the asset or simply buy the power.
A solar plant is built in a special purpose vehicle in which your company holds at least 26% equity and consumes at least 51% of the generation. Power is wheeled to your plant over the PSPCL network. Because the arrangement qualifies as captive, cross-subsidy surcharge does not apply — which is what makes the landed cost materially lower than a grid tariff.
| Item | Applies to Group Captive |
|---|---|
| Cross-subsidy surcharge | Exempt |
| Additional surcharge | As notified |
| Wheeling & transmission charges | Applicable |
| Banking | Per PSERC order |
| Consumer equity in SPV | ≥ 26% |
| Consumption by captive group | ≥ 51% |
Charges are revised by PSERC from time to time. Every proposal is worked out on the order in force on its date — see the current figures and official orders on Policy & Charges, or run your own numbers in Investor Tools.
The fastest route to lower power cost when you have shed area and daytime load. Generation offsets consumption directly behind the meter, with no wheeling charges and no transmission losses. Sizing is set by your daytime demand and your connection's net metering limit — not by how much roof happens to be free.
| Roof area per 100 kWp | ≈ 8,000–10,000 sq ft |
|---|---|
| Annual yield | ≈ 1,500–1,650 kWh/kWp |
| Typical CUF | 17–19% |
| Module warranty | 25–30 years performance |
| Delivery model | CAPEX or RESCO |
Indicative planning ranges for Punjab. Site-specific figures follow the structural and shadow survey.

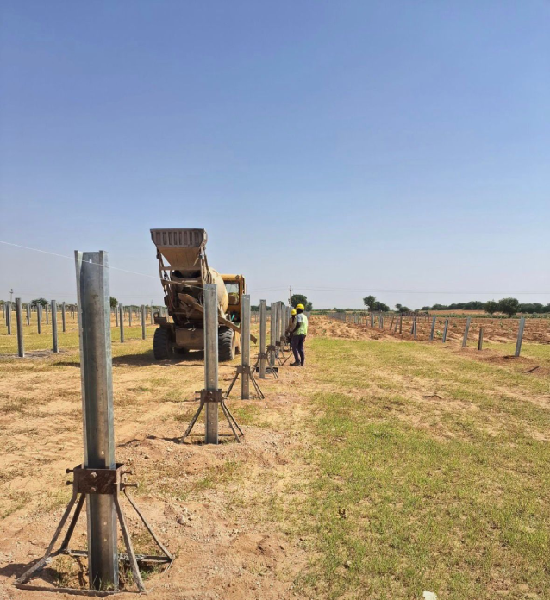

When rooftop area cannot carry the load, generation moves to land. These projects are won or lost on two questions asked early: does the nearest substation have evacuation headroom, and can the land be tied up cleanly. Engineering follows those answers — module technology, tracker or fixed tilt, and HT connectivity design.
| Land requirement | ≈ 3.5–4.5 acres per MWp |
|---|---|
| Capacity band | 1–25 MWp |
| Structure | Fixed tilt / single-axis tracker |
| Connection | 11 kV / 33 kV / 66 kV |
| Common model | Group Captive SPV |
For consumers who would rather not put capital into a power plant. BPD funds, builds, owns and operates the asset; you sign a long-term power purchase agreement and pay a fixed per-unit tariff, escalating on an agreed schedule, for the energy you actually consume. Savings begin from the first billed month.
| CAPEX | RESCO / PPA | |
|---|---|---|
| Upfront investment | You | BPD |
| Asset ownership | You | BPD |
| Accelerated depreciation | Yours | Not applicable |
| O&M responsibility | Contracted | BPD |
| Generation risk | You | BPD |
| You pay for | The plant | Units consumed |
Bank-ready detailed project reports: resource assessment, generation modelling, layout, connectivity, cost and financial returns.
Open access, connectivity, net metering, SLDC registration and PSERC filings — prepared, submitted and followed through.
Performance monitoring, cleaning cycles, preventive maintenance, monthly settlement and banking reconciliation.
Send your load details and last twelve bills. We will come back with the two options that actually apply to your connection, and the arithmetic behind each.
Explore our project photographs below. The separate illustrative profiles explain typical project configurations and commercial models.
19 images · Select a photo to explore



















Representative project profiles illustrating typical capacity, model and siting decisions. Capacities are indicative of the segment, not a claim about a specific commissioned plant.
Tell us the segment, the location and the load. We will tell you which of these shapes it fits.
Which states allow open access, how much a factory can actually install, and — for a Punjab Group Captive or open-access project — the wheeling, transmission, banking, cross-subsidy and GST charges that apply. Every figure below is sourced to the regulator, the DISCOM or CBIC, with the official order or PDF linked at each point. Charges are revised periodically — always confirm the order in force on your proposal date.
The Electricity (Promoting Renewable Energy Through Green Energy Open Access) Rules, 2022 set the national floor: any consumer with a connected/contracted load of 100 kW or more can seek open access to buy green power. For the Group Captive route there is no load threshold at all — sizing is set entirely by the 26% equity / 51% consumption test under Rule 3, not by a capacity cap.
In Punjab specifically: rooftop net-metering for a commercial or industrial connection is capped at 1 MW per connection. A Group Captive or open-access ground-mount plant carries no such cap — it is sized to your land, the evacuation headroom at the nearest substation and your consumption, not a policy ceiling.
Open-access "friendliness" — approval speed, connectivity process, surcharge levels — varies by state. Industry read: comparatively easier in Rajasthan, Gujarat, Karnataka and Madhya Pradesh; more procedure and higher surcharges in Maharashtra, Uttar Pradesh, Haryana, Tamil Nadu, Telangana and Bihar. Punjab is workable on the Group Captive route — the wheeling, loss and surcharge figures below are what make up the landed cost here.
| Route | Cap |
|---|---|
| Rooftop net-metering (C&I, Punjab) | Up to 1 MW / connection |
| Group Captive / open access, ground mount | No regulatory cap |
| Standard (non-captive) open access | ≥ 100 kW load to qualify |
Ground-mount Group Captive capacity is a site and consumption question, not a licensing one — subject to substation evacuation headroom.
The consuming entity (or group of consumers) must hold at least 26% of the equity in the generating company, and consume at least 51% of the electricity generated, measured annually on a financial-year basis. For an association of persons, consumption must track ownership share within a 10% variance. Fall short in any year and the supply is reclassified as ordinary sale, losing the captive exemption.
Electricity Rules, 2005 — official PDF ↗Set the 100 kW open-access eligibility floor, removed any load limit for the captive/Group Captive route, capped approval timelines (nodal agency to decide within 15 days), and standardised green tariff determination across states — the framework Punjab's own open access process sits under.
Ministry of Power — official announcement ↗What PSPCL bills on wheeled energy under the tariff order effective 1 April 2025 – 31 March 2026. These are exactly the defaults our Investor Tools calculator starts from.
| Charge | Rate | Notes |
|---|---|---|
| Wheeling charge | ₹2,85,216 / MW / month (long/medium-term OA) ₹685.88 / MWh (short-term OA) | Long/medium-term is a capacity charge, not per-unit; ≈ ₹0.69/unit on a short-term basis |
| Transmission & distribution loss | 2.21% at 132/220/400 kV 3.99% at 66/33 kV 6.97% at 11 kV | Borne in kind — deducted from wheeled energy; higher at lower connection voltage |
| Cross-subsidy surcharge (CSS) | Large Supply ₹0.57/unit Non-Residential ₹1.11/unit Bulk Supply ₹0.85/unit | Waived entirely for a qualifying Group Captive consumer |
| Additional surcharge | As notified — set separately for full and partial open access | Applies even to captive consumers (only CSS is captive-exempt); confirm the current rate from PSERC before quoting |
| Banking loss | Per the PSERC Open Access Regulations in force | Typically a single-digit % of banked units |
Under CBIC Circular No. 163/19/2021-GST (6 October 2021), a solar power generating system supplied as a composite works contract is valued as 70% goods and 30% services. Goods attract 5% GST, services attract 18% GST — a blended effective rate of about 8.9% on the total contract value, not a flat 18%.
General information, not tax advice — GST treatment can differ if goods and services are billed under separate contracts. Confirm applicability to your specific structure with your CA.
| Component | Share | GST rate |
|---|---|---|
| Goods (modules, inverters, structure, cable, etc.) | 70% | 5% |
| Services (installation, commissioning) | 30% | 18% |
| Blended effective rate | 100% | ≈ 8.9% |
Punjab State Electricity Regulatory Commission — regulations, tariff orders and public notices.
Open ↗Wheeling, transmission & distribution loss and cross-subsidy surcharge — commercial circular.
Open PDF ↗Consolidated supply code governing metering, billing and connection terms.
Open PDF ↗Rule 3 — the 26% equity / 51% consumption test for a Captive Generating Plant.
Open PDF ↗National open-access eligibility framework — Ministry of Power.
Open ↗CBIC clarification on the 70:30 goods/services valuation for solar power projects.
Open PDF ↗This page is a plain-language summary for planning purposes, not legal or tax advice. Regulatory charges are revised periodically by PSERC/PSPCL and tax notifications by CBIC — always confirm against the order in force before finalising a proposal.
Use the figures above as the defaults, then design your own plant and see the full 25-year picture.
Set a capacity, a tariff and a financing structure, and this page builds the same model our DPRs are built from — generation, Group Captive charges, energy accounting, and a full 25-year cash flow with IRR, DSCR, NPV, payback and PAT. Every field is editable; nothing here is locked to a template.
Defaults are typical Punjab industrial assumptions. Change anything — every output recalculates immediately.
₹4.30/unit is BPD's own indicative 2026 Punjab park rate on the client side — replace it with your own quoted or target tariff.
Defaults are PSPCL's FY 2025-26 order for a Large Supply industrial connection: wheeling ≈ ₹0.69/unit (short-term open access), CSS ₹0.57/unit (Non-Residential ₹1.11, Bulk Supply ₹0.85 — pick per your category), T&D loss shown as an approximate ₹/unit equivalent (actual: 2.21%–6.97% of energy, by voltage). Additional surcharge defaults to 0 — insert the current PSERC-notified rate before quoting, it is not captive-exempt. Full figures, official orders and PDFs: Policy & Charges.
Settlement between Group Captive generation and your consumption is done block-by-block (96 × 15-minute blocks/day). Only the shortfall in each block — Import from grid — is billed at the grid/DISCOM rate; surplus is banked, not shown as a separate export line here.
Indicative model for planning discussions only — not a substitute for an audited DPR, a lender's technical due diligence, or your CA's tax computation.
Same consumption, three ways to pay for it — monthly, year 1.
—
—
—
Per-unit charges on wheeled energy vs. your PPA tariff and the grid tariff.
| Component | ₹ / unit |
|---|
Generation vs. consumption across a representative day. Only Import from grid is tracked as a settlement line, per BPD's accounting convention — surplus blocks are banked, not shown as export.
| Time block | Generation (kWh) | Consumption (kWh) | Import from grid (kWh) |
|---|
Generation, revenue, O&M, land rent, EMI, tax and cash flow, year by year.
| Yr | Gen (units) | Revenue (₹L) | O&M (₹L) | Land rent (₹L) | EBITDA (₹L) | Deprec. (₹L) | EBIT (₹L) | Interest (₹L) | PBT (₹L) | Tax (₹L) | PAT (₹L) | Principal (₹L) | DSCR | Net CF to equity (₹L) | Cumulative CF (₹L) |
|---|
Share your load details and recent electricity bills and we will come back with an indicative capacity, the delivery model that fits, and what it is worth to you per year.
Large files? Email them directly to varinder@bpse.co.in.
